Sri Vaikuntam

Nanganallur

Download Brochure

Download file

Enquire Now

Amenities

Generator Backup
CCTV
Elevators
Rain Water Harvesting

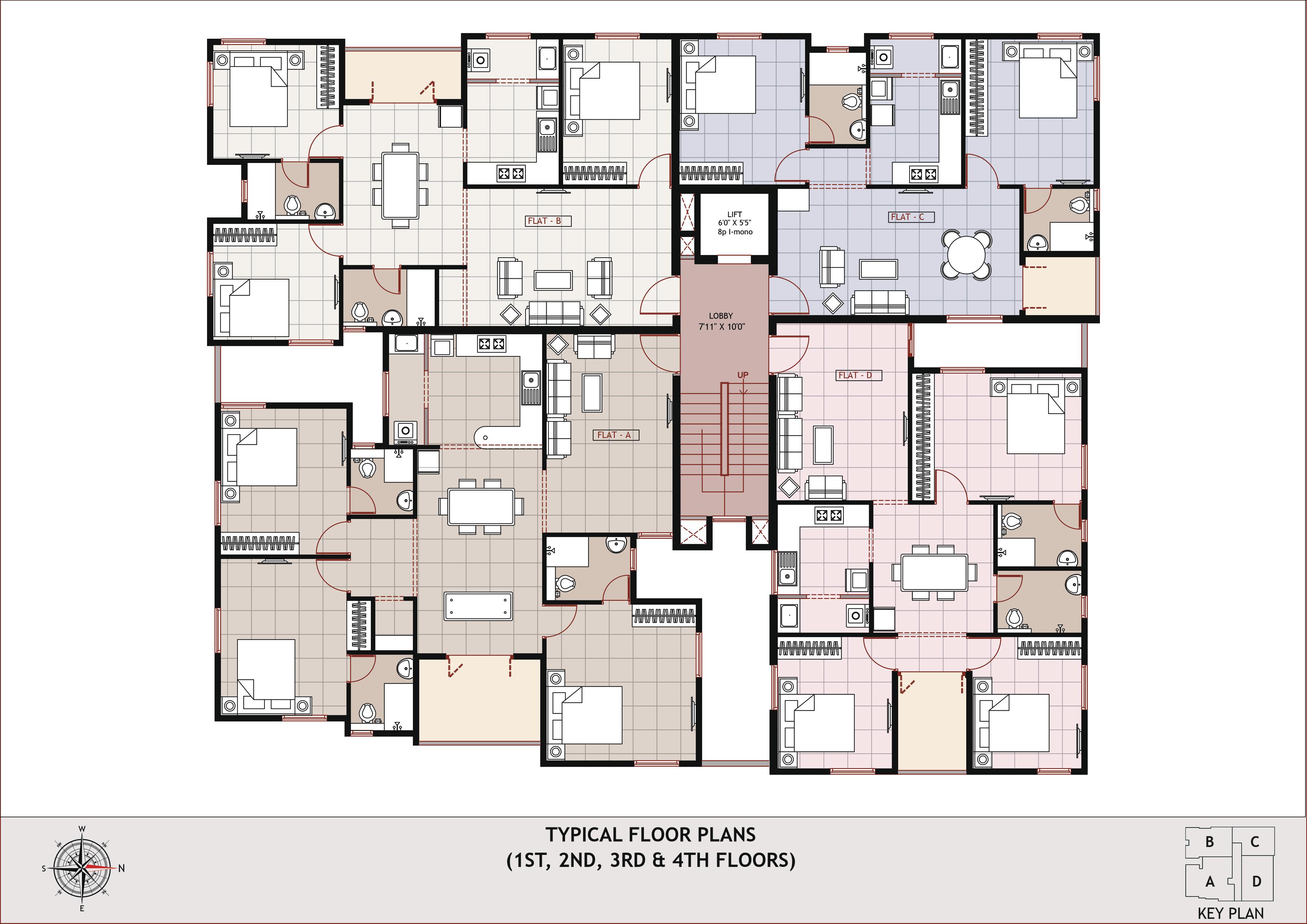

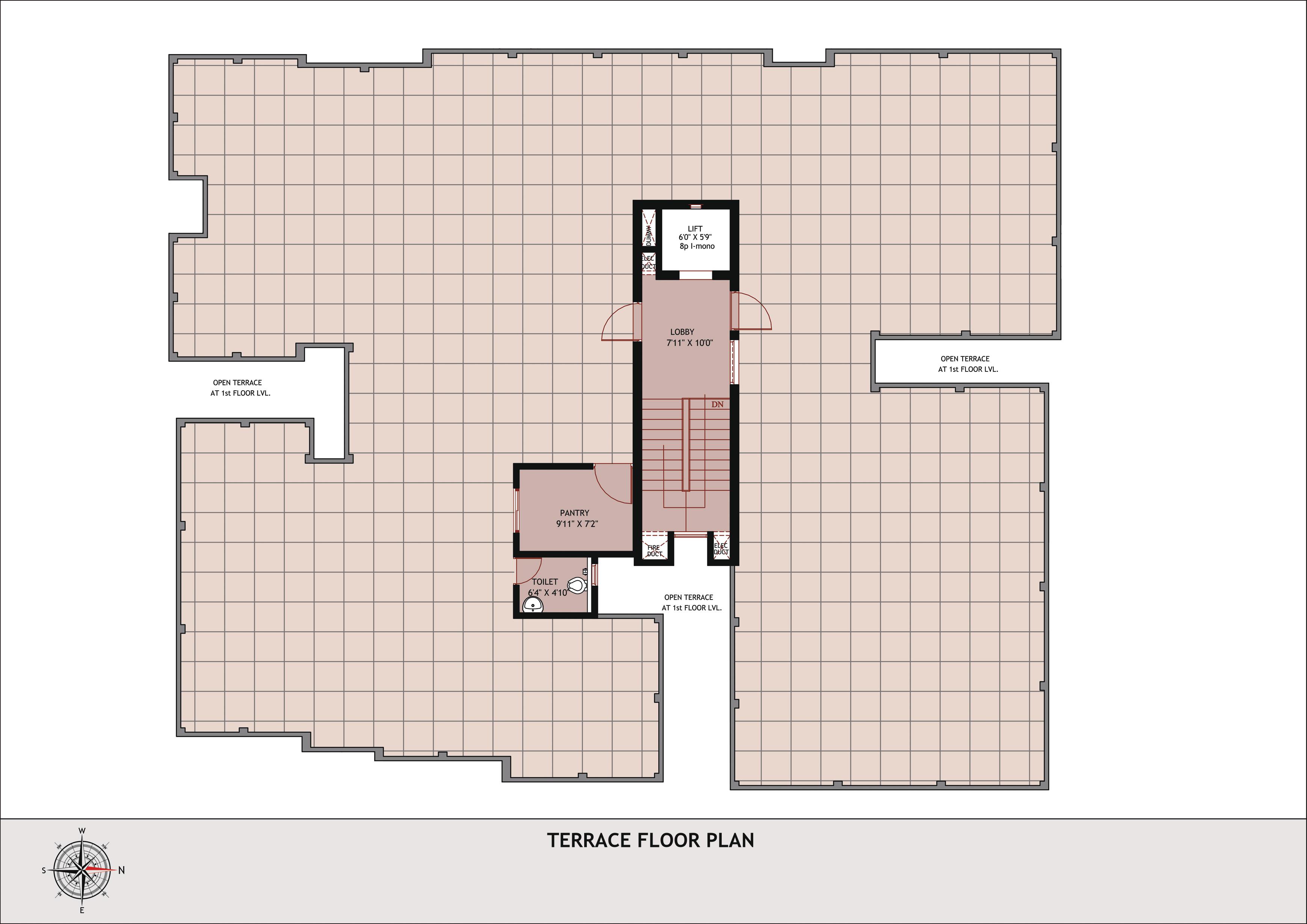

Master Layout Plan

Approvals

Planning Permit No:

OL - PP / NHRB / 0404 / 2023, Permit No. OL – 00552

Date of Permit:

2023-10-16

Building Permission No:

CEBA / WDCN12 / 00403 / 2023

Date of Permit:

2023-11-02

TNRERA:

TN / 29 / Building / 0465 / 2023

Dated:

2023-11-22

Project Update Images

  • 5th floor block work is completed.
  • 3rd floor gypsum plastering work is completed.
  • 4th floor gypsum plastering work is in progress (70% completed)
  • 4th floor toilet plumbing work is in progress.
  • All floors Lobby and Staircase wall plastering work is in progress.
  • External plastering work is in progress. (50% completed)
  • 3rd floor gypsum plastering work is completed.
  • 4th floor gypsum plastering work is in progress (70% completed)
  • 4th floor toilet plumbing work is in progress.
  • All floors Lobby and Staircase wall plastering work is in progress. (90% completed)
  • 1st floor toilet wall tile laying work is in progress.
  • 4th floor gypsum plastering work is completed.
  • 5th floor gypsum plastering work is in progress (50% completed)
  • 4th floor toilet plumbing work is in progress.
  • All floors Lobby and Staircase flooring work is in progress.
  • 1st and 2nd floor toilet wall tile laying work is in progress.
  • External plastering work is in progress. (75% completed)
  • 4th floor gypsum plastering work is completed.
  • 5th floor gypsum plastering work is in progress (90% completed)
  • 4th floor toilet plumbing work is in progress.
  • All floors Lobby and Staircase flooring work is in progress.(90% completed)
  • 1st and 2nd floor toilet wall tile laying work is in progress.(50% completed).
  • 1st floor general flooring work is in progress.
  • External plastering work is in progress. (85% completed)
  • Elevation brick cladding work is in progress.
